Process of Building a Custom Home in Texas

Table Of Contents
Share

Fred Loucks is CEO of Dunn & Stone Builders. He joined the company in 2010 as purchasing manager, bought it in 2019, and works with families on plan design. Dunn & Stone has built more than 1,000 homes in the Greater Houston area since 1999.

Most first-time custom home buyers plan around the months of construction. Design, permitting, and the construction loan often take as long as the house itself.

We've built more than 1,000 homes in the Houston area since 1999. Design, permits, and the loan have to finish before the slab. When they do, crews are not standing around waiting on paperwork.

This guide walks the process of building a custom home in Texas from the first budget conversation to keys.

Key Takeaways

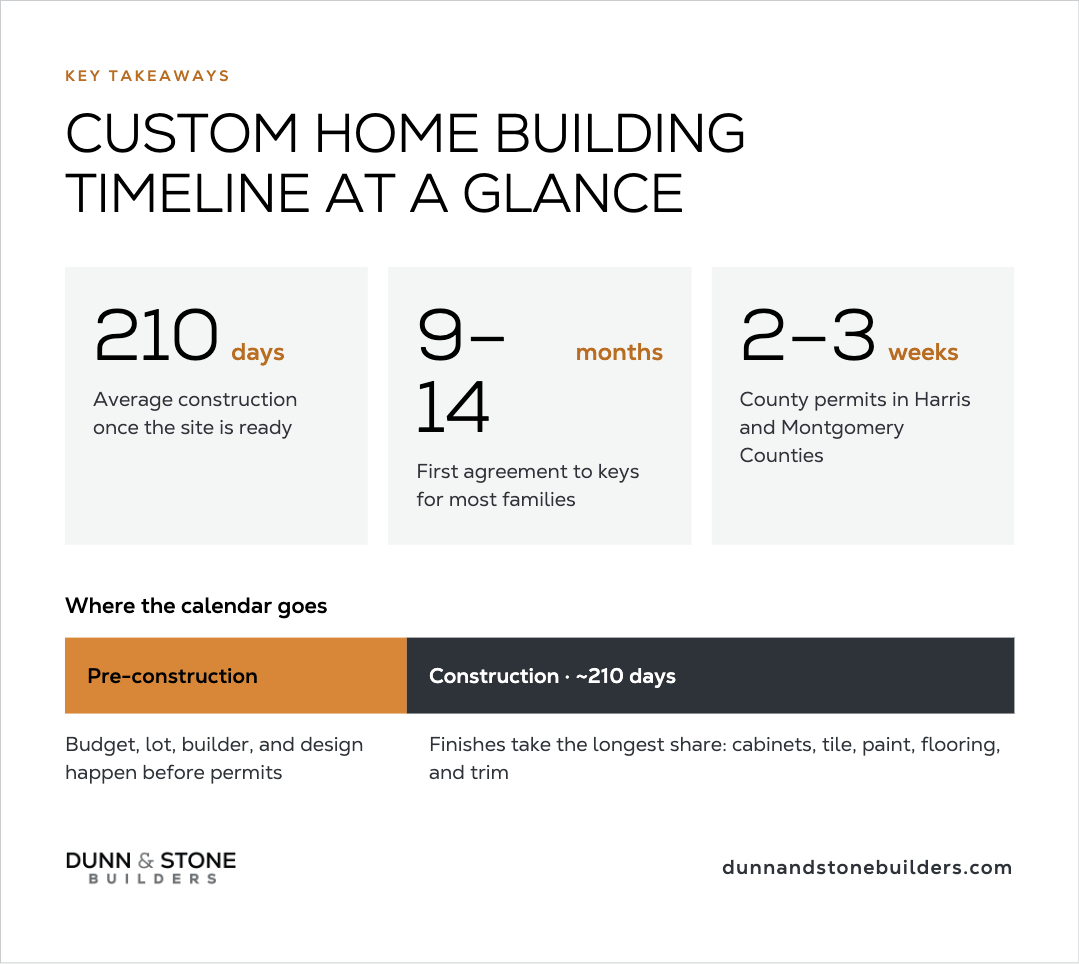

Key Takeaways graphic “Custom Home Building Timeline at a Glance”: 210 days average construction once the site is ready, 9–14 months from first agreement to keys, and 2–3 weeks for Harris and Montgomery County permits; bar of pre-construction vs construction (~210 days) noting finishes take the largest share.
  • Once the site is ready, construction in the Houston area averages 210 days. From first agreement to keys, most families land on 9 to 14 months.
  • Budget, lot, builder, and design happen before permits. Those early choices are what later show up in cost and schedule.
  • Finishes take the longest share of construction. Cabinets, tile, paint, flooring, and trim fill most of those weeks.
  • County permits in Harris and Montgomery Counties usually take two to three weeks.

What the Home Building Process Looks Like, Start to Finish

The process of building a custom home runs through three stages: pre-construction, construction, and closeout.

Pre-construction covers financing, the lot, design, approved finish selections, soils, construction drawings, the permit, and the loan. Construction is site work through finishes. Closeout is final inspections, the certificate of occupancy, the walkthrough, and keys.

Most of the decisions that affect timeline and budget happen in the first stage, before anyone breaks ground.

  1. Set the budget and line up financing.
  2. Evaluate the lot, or start from land you already own.
  3. Choose the builder.
  4. Design the house and lock selections.
  5. Pull permits and finish pre-construction documents.
  6. Prepare the site and pour the foundation.
  7. Frame the house and get it weather-tight.
  8. Rough in plumbing, electrical, and HVAC.
  9. Insulate, hang drywall, and complete finishes.
  10. Pass final inspections, walk the house, and close.
StageTypical windowWhat happens
Pre-construction2 to 6 monthsFinancing, lot work, design, selections, soils, permit, loan
Site and foundation2 to 4 weeksClearing, grade, slab or piers, cure, inspection
Framing and weather-tight shell1 to 2 monthsWalls, roof, windows, wrap
Mechanical rough-in1 to 2 monthsPlumbing, electrical, HVAC, inspections
Insulation, drywall, and finishes8 to 14 weeksDrywall, cabinets, tile, paint, flooring, trim, siding or brick
Inspections and closeout2 to 4 weeksFinal inspection, certificate of occupancy, walkthrough, keys

‍

‍

The version we walk with a family, from first meeting through construction, is in the 5 steps to building a custom home.

Step 1: Set Your Budget and Secure Financing

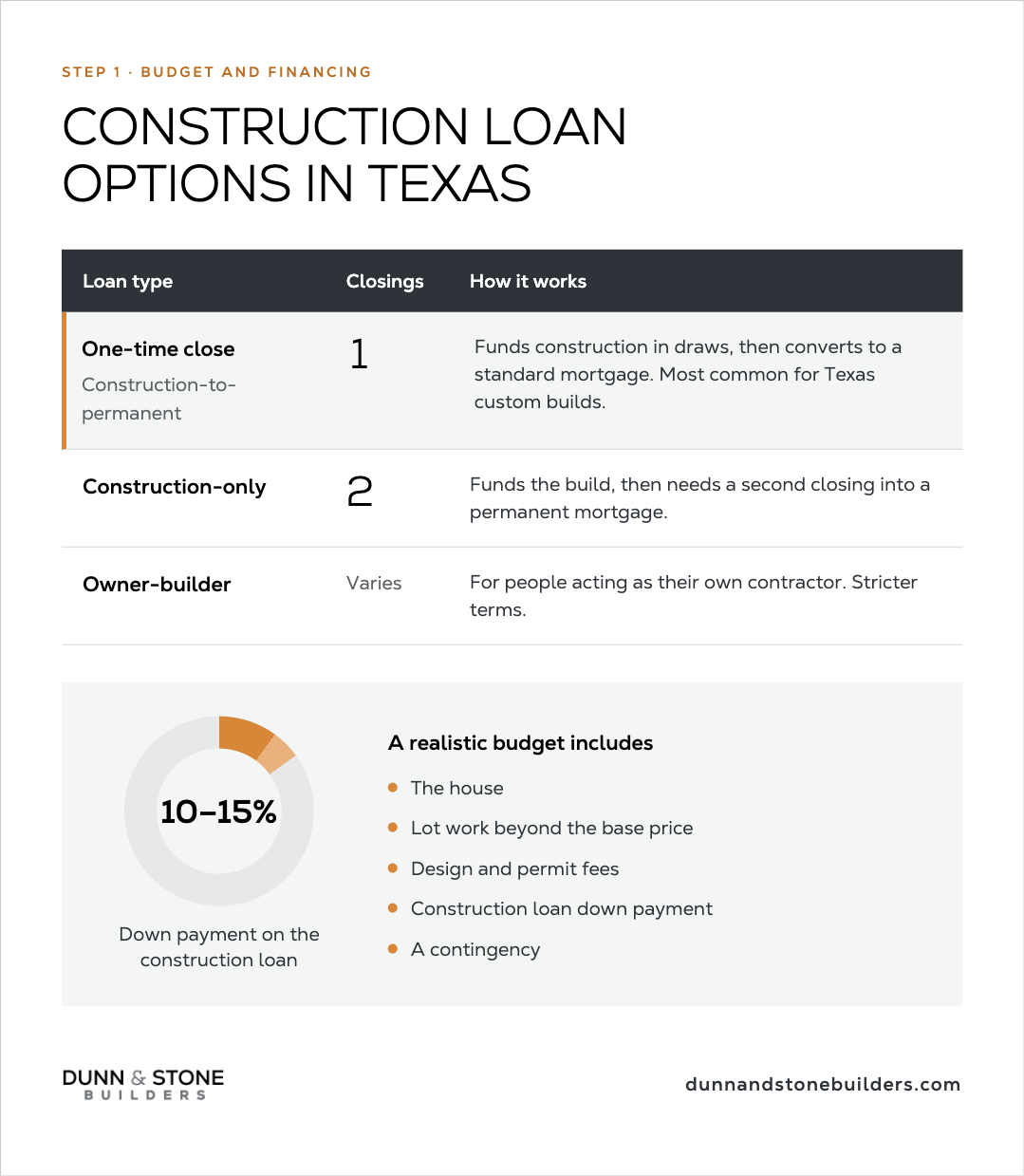

Step 1 Budget and Financing: Texas construction loan options—one-time close (1 closing, most common), construction-only (2 closings), owner-builder (varies, stricter); 10–15% down-payment donut and a realistic-budget checklist (house, lot work beyond base, design and permit fees, down payment, contingency).

You can't design the right house until you know what you can spend.

Most Texas custom builds use a construction-to-permanent loan, also called a one-time close loan. It funds construction in draws, then converts to a standard mortgage when the house is complete. During construction you pay interest on the amount drawn. One closing covers the conversion.

A construction-only loan funds the build and then requires a second closing into a permanent mortgage. That path adds a second round of paperwork. Owner-builder loans exist for people who act as their own contractor. Those loans are stricter, and they are not how we work.

A realistic budget includes the house, lot work above what the base price already covers, design and permit fees, a 10% to 15% down payment on the construction loan, and a contingency. Texas property taxes belong in the monthly payment once the house is complete.

Get a lender's range before you pick a floor plan. The loan types and draw schedule are covered in how to get a loan to build a house.

Step 2: Find and Evaluate Your Lot

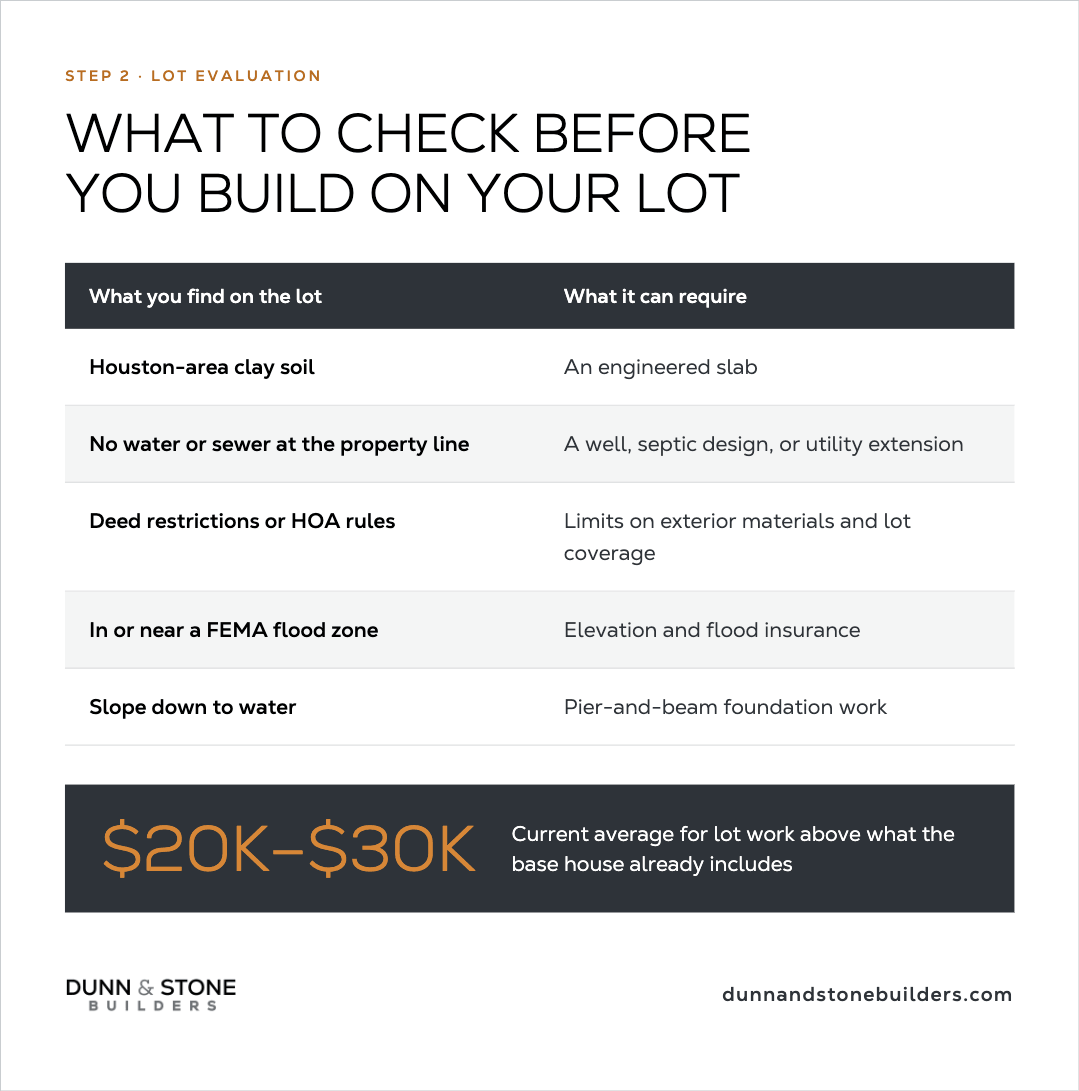

Step 2 Lot Evaluation “What to check before you build on your lot”: clay soil → engineered slab; no water/sewer → well, septic, or utility extension; deed/HOA rules → material and coverage limits; FEMA flood zone → elevation and flood insurance; slope to water → pier-and-beam; $20K–$30K average for lot work above the base house.

Where you build shapes the foundation, the utilities, the permit path, and the floor plan. If you already own the land, check whether it can take the house.

Look past the listing price. Houston-area clay often needs an engineered slab. A lot without water or sewer at the property line needs a well, a septic design, or a utility extension. Deed restrictions and HOA architectural rules can limit exterior materials and lot coverage.

Flood zone status matters in Southeast Texas. A lot in or near a FEMA flood map zone may need elevation and flood insurance.

Lot work above what the base house already includes currently averages $20,000 to $30,000. Slope down to water is a different problem and can require pier-and-beam work.

Have the builder walk the tract before you commit to a plan. Soil, drainage, and utility distance belong in the price you see before you sign. For Houston-area land questions, how to build a home on land you own covers the evaluation items in more detail.

Step 3: Choose Your Builder

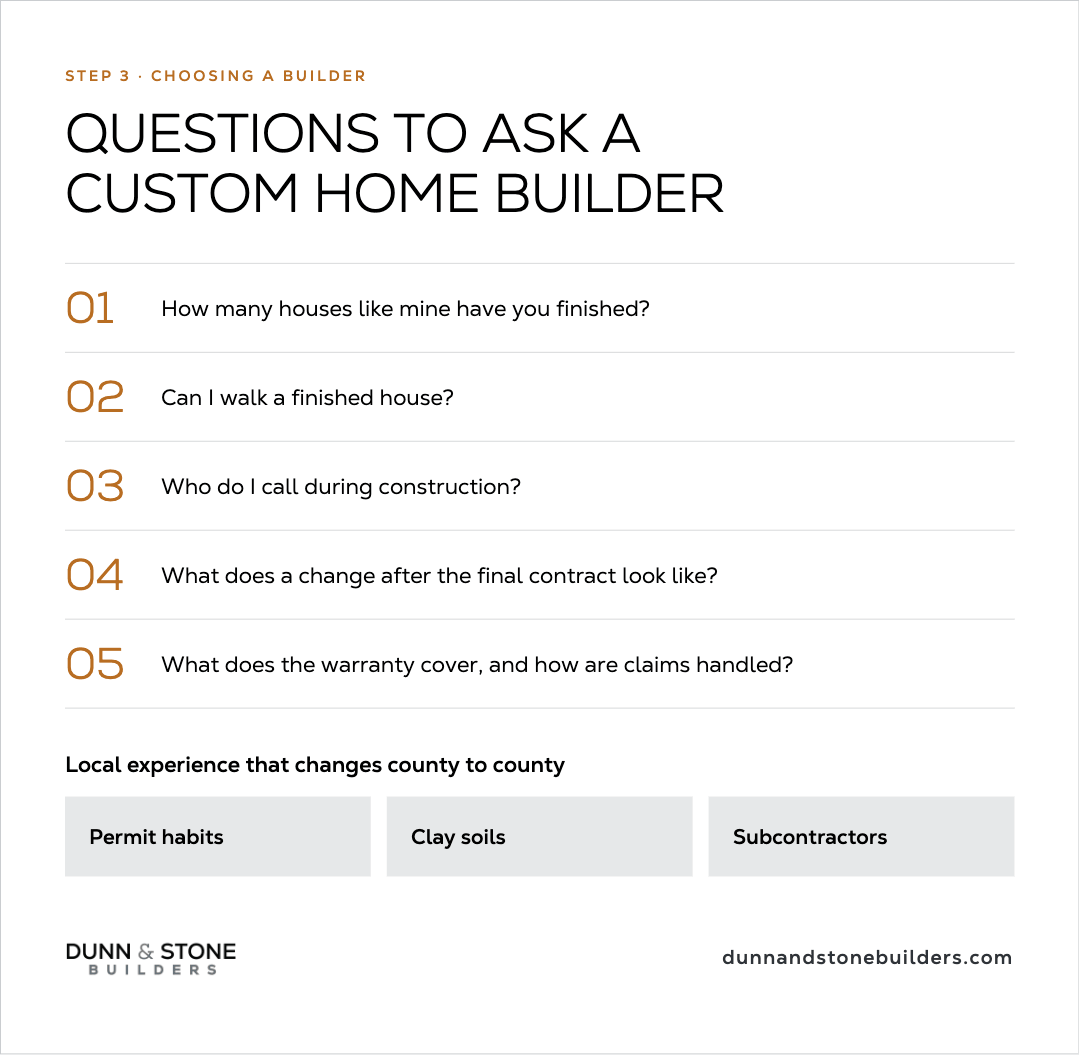

Step 3 Choosing a Builder: five questions—houses like yours finished, walk a finished house, who to call during construction, changes after the final contract, warranty and claims—plus local experience that changes county to county (permit habits, clay soils, subcontractors).

The builder runs the rest of the process: trades, permits, inspections, and the weekly updates you will live with for a year.

Ask how many houses like yours they have finished, and walk one. Ask who you call during construction, and what a change after the final contract actually looks like.

Local experience matters in Harris and Montgomery Counties. Permit habits, clay soils, and the subcontractors a builder already uses are not the same from one county line to the next. Warranty coverage and how claims actually get handled belong in the same conversation.

Walk a finished house before you hire the builder. Website photos leave out the rooms you actually live in.

Step 4: Design the Home and Lock Selections

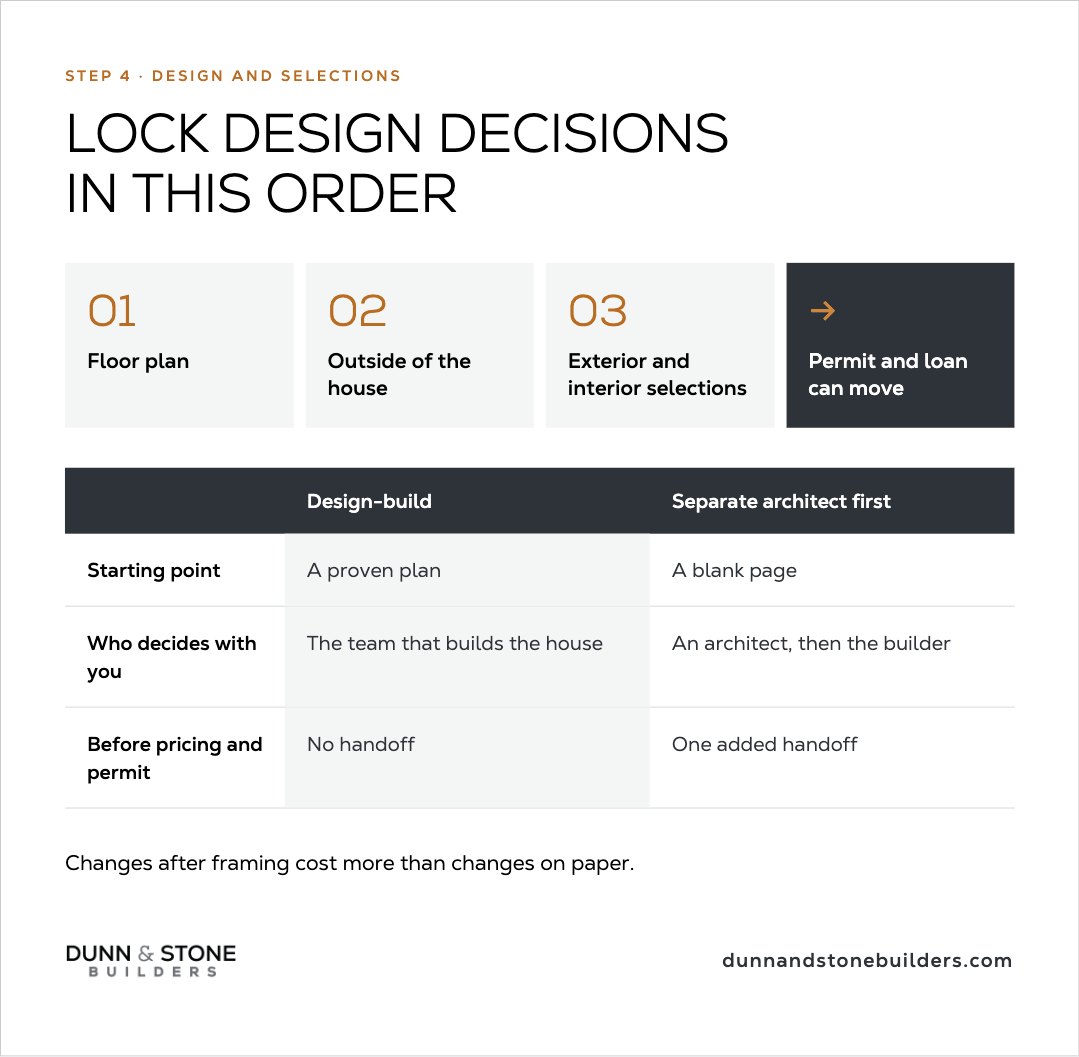

Step 4 Design and Selections “Lock design decisions in this order”: floor plan → outside of the house → exterior and interior selections, then permit and loan; design-build vs separate architect first comparison; note that changes after framing cost more than changes on paper.

Design is the stretch where the floor plan, the outside of the house, and the finishes get decided. If those choices stay open, the permit and the loan wait.

On a design-build path, you start from a proven plan, then settle the floor plan, the look of the outside, and the interior selections with the same team that will build the house. Working with a separate architect first gives more freedom on a blank page. It also adds a handoff before anyone can price or permit the drawings.

I see meetings run long when a floor plan that was already settled gets opened again. Finish the plan, then the outside of the house, then the exterior and interior selections. A new layout at the last design meeting pushes the permit and the loan.

Special-order cabinets, windows, and tile carry lead times that start when the choice is locked, not when the installer arrives. Changes after framing cost more than changes on paper.

Materials and finishes belong in this same stretch. Work inside the products your builder can warrant and restock later.

Step 5: Permits and Pre-Construction

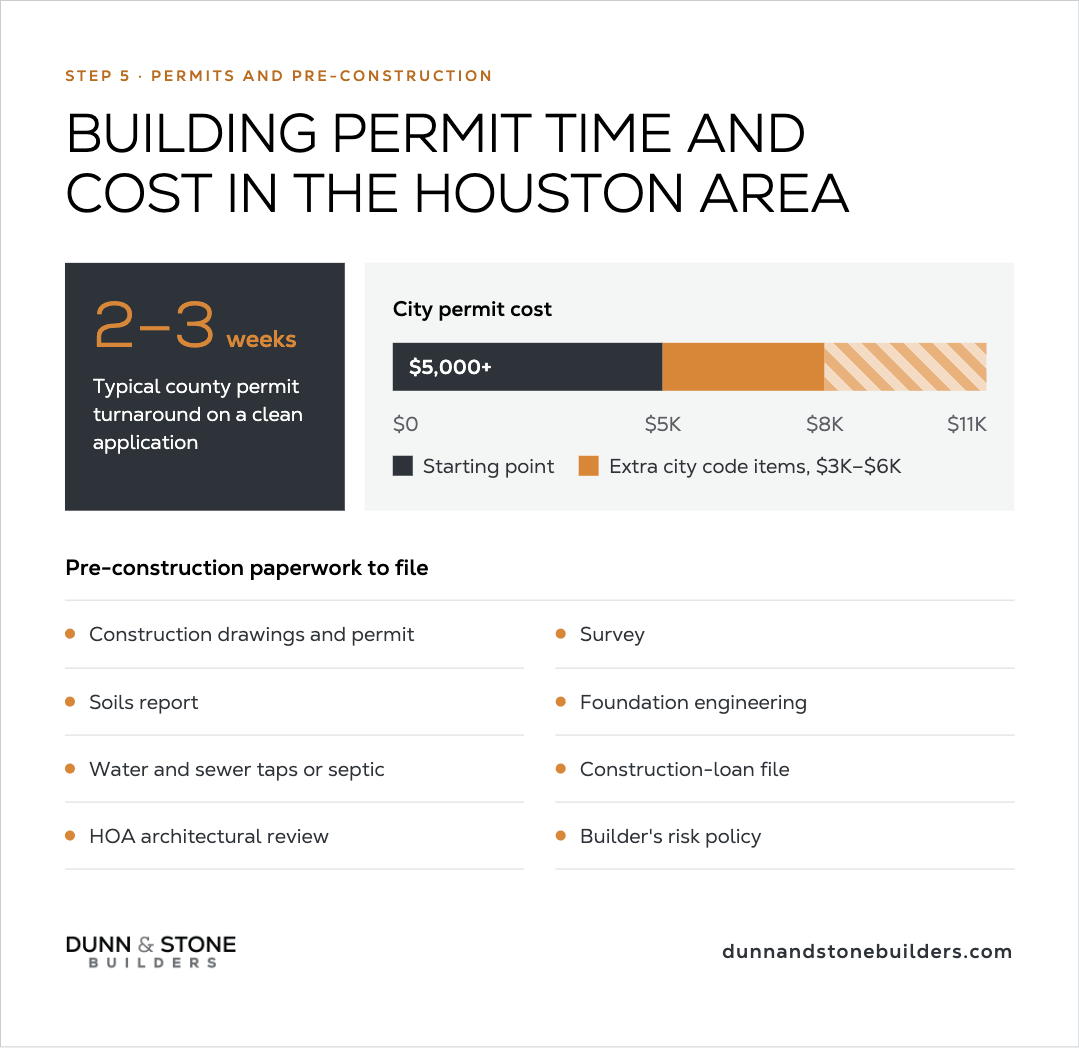

Step 5 Permits and Pre-Construction: typical county permit turnaround 2–3 weeks on a clean application; city permit cost from $5,000+ plus $3K–$6K extra code items; pre-construction paperwork checklist (drawings and permit, soils, taps or septic, HOA review, survey, foundation engineering, construction-loan file, builder’s risk).

Most buyers are surprised by how much still sits between a signed design and the first crew.

The builder submits the construction drawings and applies for the building permit. In our Texas counties, a clean county application usually turns around in two to three weeks. Harris County has gotten stricter on fill in floodplain areas. Montgomery County is moving in the same direction. Inside a city, permitting commonly starts at $5,000, and extra city code items can add another $3,000 to $6,000.

The same stretch includes the survey, the soils report, foundation engineering, water and sewer taps or a septic design, the lender's construction-loan file, and HOA architectural review when the community requires it. A builder's risk policy insures the house while it is under construction. Your homeowners policy takes over at completion.

File the survey, soils, permit, and loan paperwork as soon as the design is finished so the crew is not waiting on paper.

Step 6: Site Preparation and Foundation

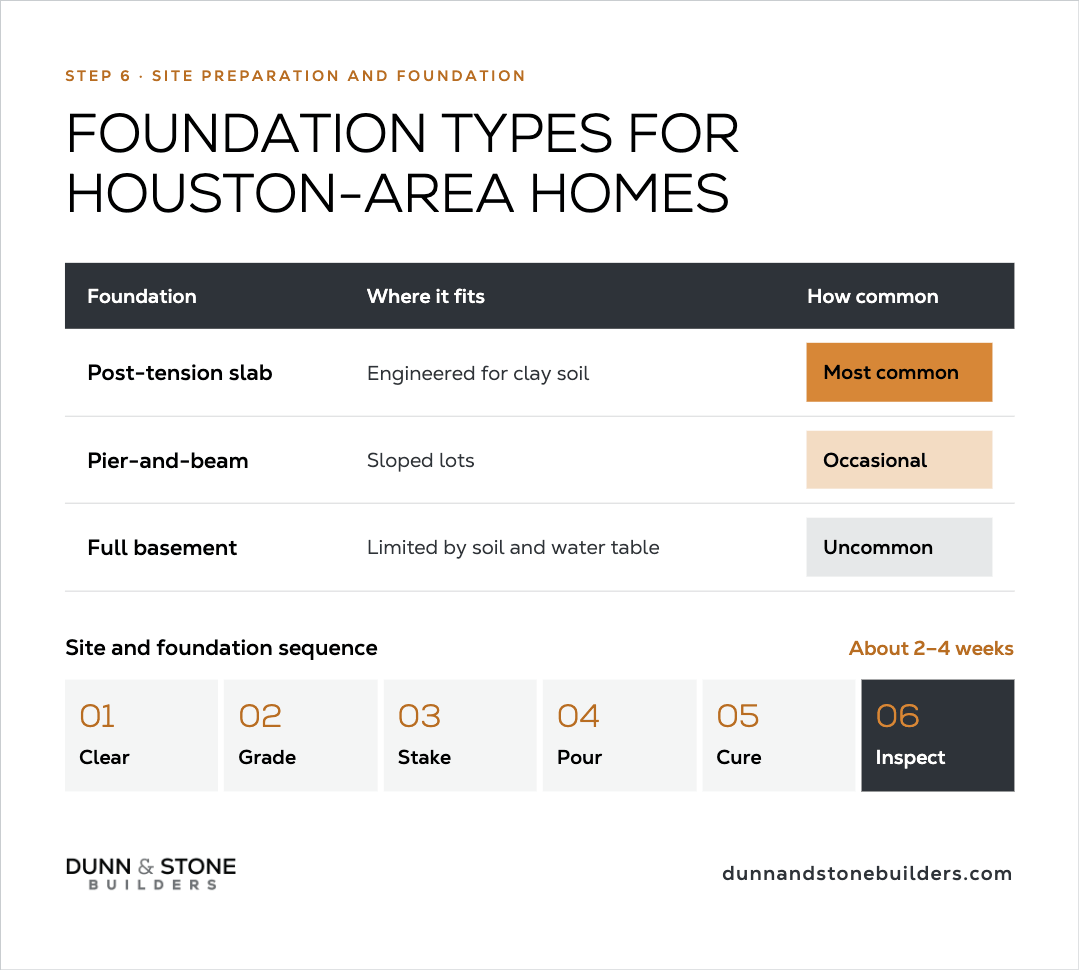

Step 6 Site Preparation and Foundation: foundation types for Houston-area homes—post-tension slab (most common, engineered for clay), pier-and-beam (occasional, sloped lots), full basement (uncommon); about 2–4 weeks sequenced Clear → Grade → Stake → Pour → Cure → Inspect.

The crew clears the tract, grades for drainage, and stakes the foundation. In the Houston area the common foundation is a post-tension slab engineered for clay. Pier-and-beam shows up on sloped lots. Full basements are uncommon here because of soil and the water table.

After the pour, the slab has to cure. A city or county inspector signs off before framing starts. Problems under the house are the expensive ones, because nothing above it can be repaired without going back to the foundation.

This stage usually runs about two to four weeks when the weather cooperates.

Step 7: Framing

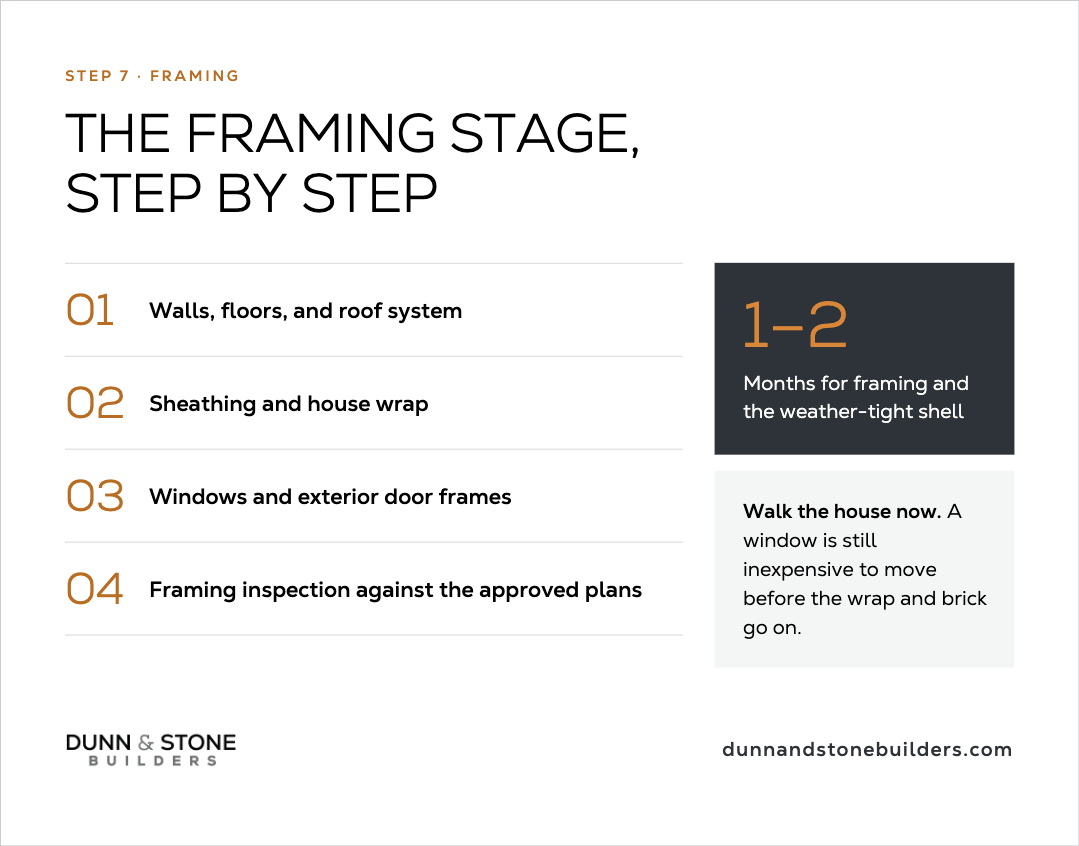

Step 7 Framing step by step: walls/floors/roof system, sheathing and house wrap, windows and exterior door frames, framing inspection against approved plans; 1–2 months for framing and the weather-tight shell, with a tip to walk the house while a window is still inexpensive to move.

Framing is when an empty slab starts to look like a house.

Walls, floors, and the roof system go up. Sheathing and house wrap go on so liquid water stays out of the wall while vapor can still leave. Windows and exterior door frames are set. Vaulted ceilings and long spans take shape here.

A framing inspection checks the structure against the approved plans. Walk the house during this stage if your builder allows it. A window that needs to move is still inexpensive to relocate before the wrap and the brick go on.

Framing and the weather-tight shell usually take one to two months.

Step 8: Plumbing, Electrical, and HVAC Rough-In

Step 8 Mechanical Rough-In table for plumbing, electrical, and HVAC (installs, plan-ahead items including two AC units over 3,000 sq ft, required inspections each); 1–2 months, all three inspections pass before the walls close—confirm outlet placements before insulation.

During rough-in, plumbers, electricians, and HVAC crews install the systems that later sit behind the walls.

The plumber runs supply and drain lines and leaves pipe ends where sinks and toilets will go. The electrician sets the panel and pulls circuits, including any specialty runs for a shop, an EV charger, or extra lighting. HVAC crews set the air handler and the ductwork. Houses over 3,000 square feet typically get two air conditioners in the Houston area.

Each trade has its own inspection. All three have to pass before the walls close. Moving an outlet after drywall means opening the wall again. Confirm placements before the insulation goes in.

This stage usually takes one to two months.

Step 9: Insulation, Drywall, and Finishes

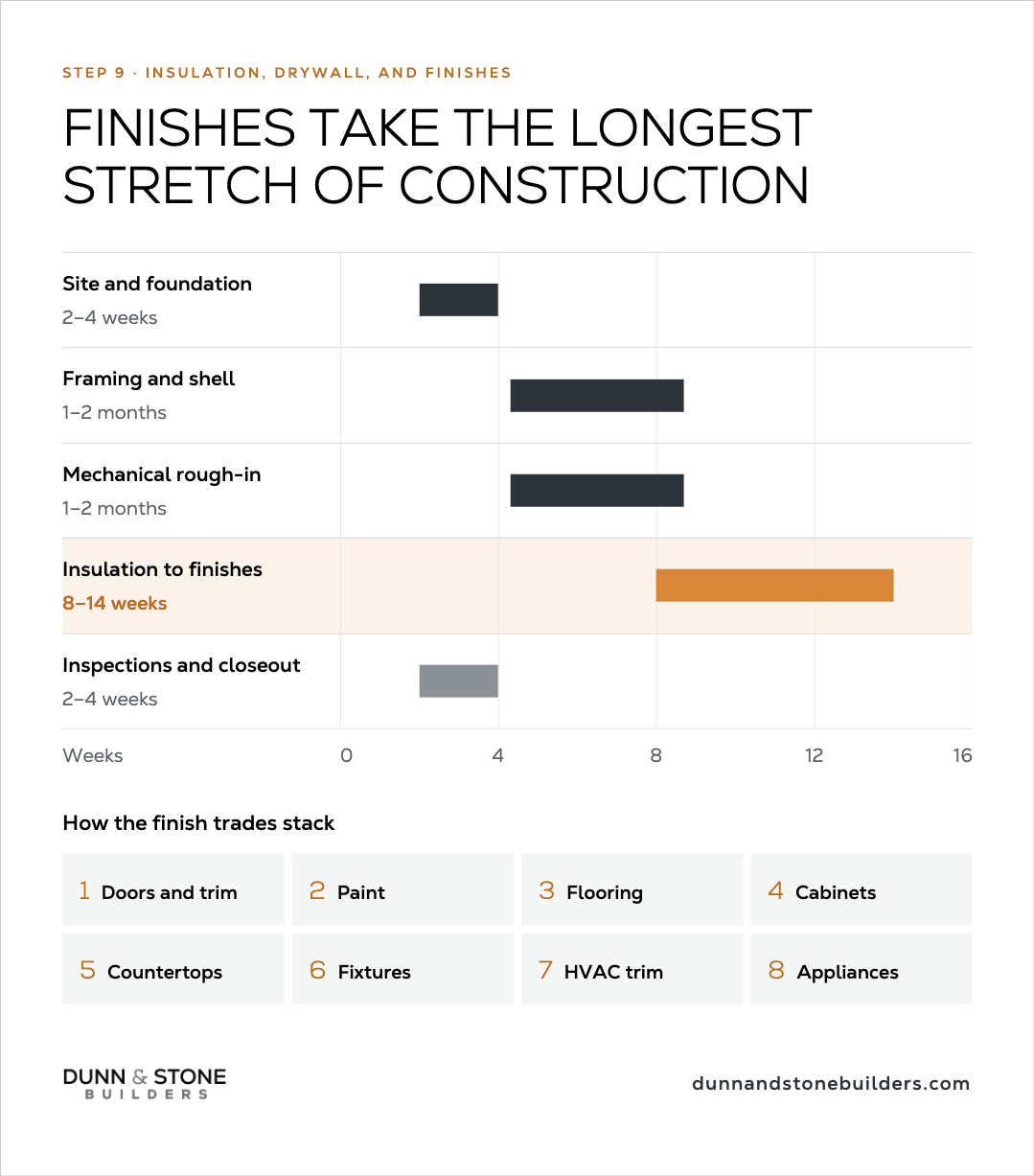

Step 9 Insulation, Drywall, and Finishes: construction-stage Gantt highlighting insulation to finishes as the longest stretch (8–14 weeks) vs shorter site, framing, rough-in, and closeout windows; numbered finish-trades stack from doors and trim through appliances.

Insulation, drywall, and finishes take the longest stretch of construction on most custom houses.

Insulation goes in the exterior walls and the attic. In Southeast Texas, attic heat is a real utility cost. After the insulation inspection, drywall goes up, gets taped, and gets primed. Outside, brick, stone, stucco, or siding can run at the same time.

Then the interior trades stack: doors and trim, paint, flooring, cabinets, countertops, fixtures, HVAC trim, and appliances. Driveways, final grade, and landscaping finish the site.

Cabinets, specialty tile, and hardwood have the longest lead times. Together, this stretch often runs eight to fourteen weeks.

Step 10: Inspections, Walkthrough, and Closing

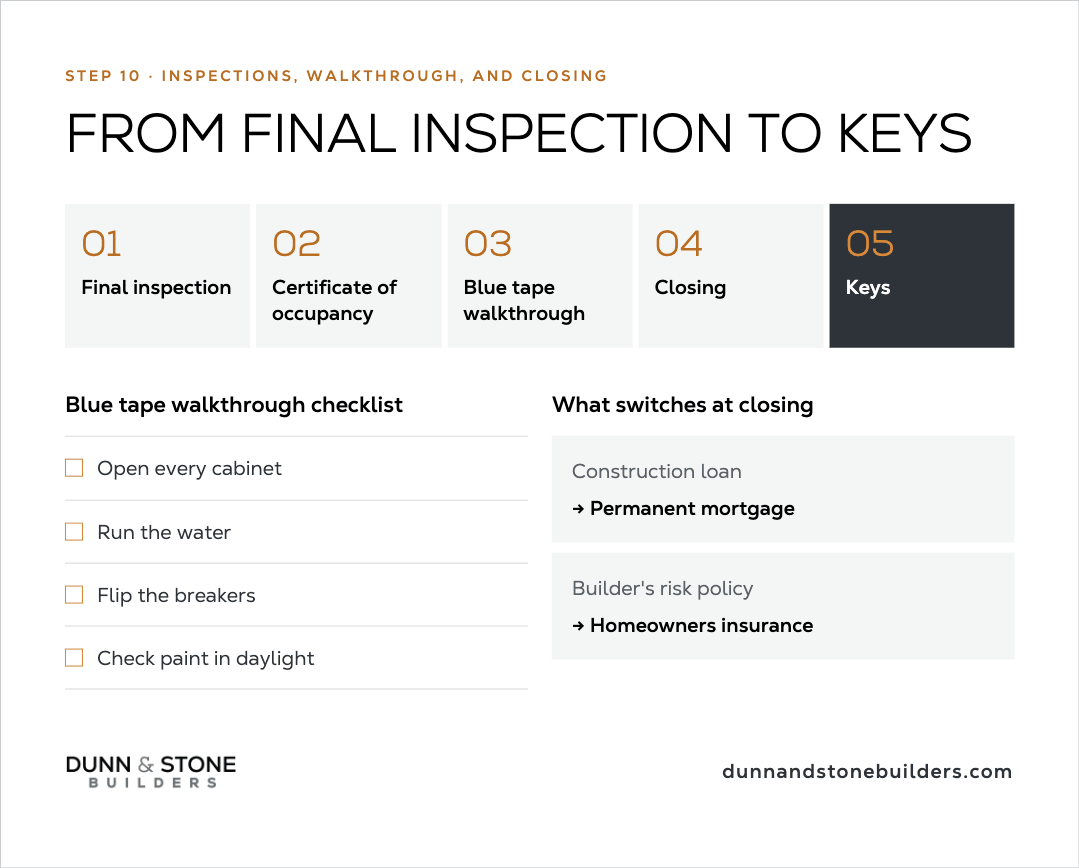

Step 10 From Final Inspection to Keys: sequence final inspection → certificate of occupancy → blue tape walkthrough → closing → keys; blue-tape checklist (cabinets, water, breakers, paint in daylight) and what switches at closing (construction loan → permanent mortgage; builder’s risk → homeowners insurance).

The local building official inspects the finished house against the approved plans. When it passes, the municipality issues a certificate of occupancy. That document is what lets you occupy the house.

The Blue Tape Walkthrough

Before closing, you walk every room with the builder and mark repairs with blue painter's tape. It is the last pass while the builder still has crews assigned to fix what you find.

Bring a list. Open cabinets, run water, flip breakers, and look at paint in daylight. The blue tape walkthrough checklist is the room-by-room version of that visit.

Closing and Keys

On a one-time close loan, the construction loan converts to the permanent mortgage at this point. You do not start a second loan application from scratch. Homeowners insurance replaces builder's risk.

You get the keys after the certificate of occupancy and after the walkthrough items that have to be done before handover.

How Long Does the Home Building Process Take in Texas?

Texas Custom Home Timeline: ~210 days construction once the site is ready vs 9–14 months from first agreement to keys; keeps it shorter (simple footprint, settled selections) vs pushes it longer (larger house, wet month on the slab).

Once the site is ready, construction on Dunn & Stone custom homes in the Houston area averages 210 days. From first agreement through design, soils, permits, the loan, and keys, most families are on a 9 to 14 month calendar.

National single-family averages sit shorter because they mix production houses built for sale with contractor-built custom work, and they start the clock at the permit. Census construction time does not count the months a custom buyer spends on a plan and a loan.

Homes with a simple footprint and settled selections stay toward the short end. A larger house or a wet month on the slab pushes the calendar out. The month-by-month construction windows live in how long it takes to build a house.

What Can Slow Down the Home Building Process?

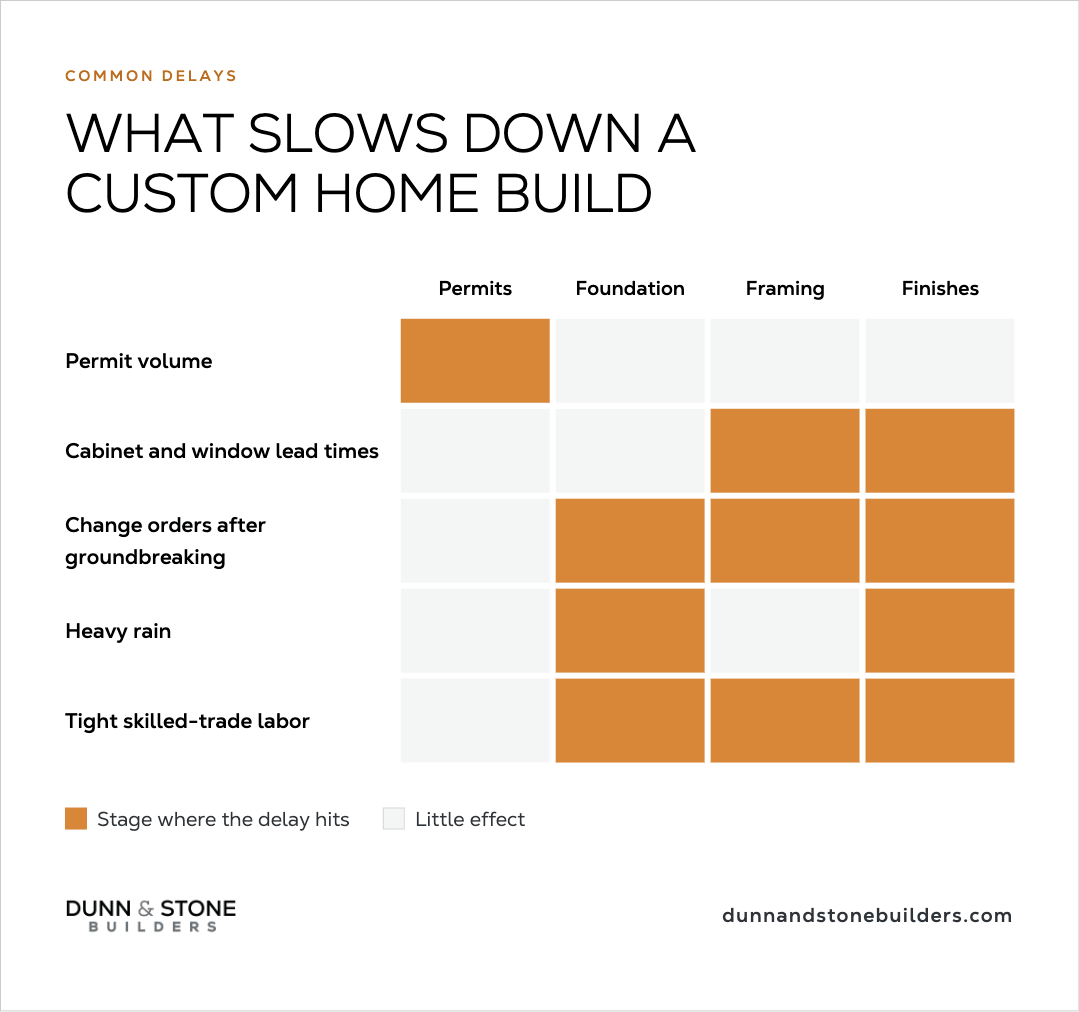

Common Delays matrix mapping permit volume, cabinet/window lead times, change orders after groundbreaking, heavy rain, and tight skilled-trade labor against permits, foundation, framing, and finishes stages (orange = stage where the delay hits).

Permit volume in growing Houston-area counties can add weeks if the drawings go in late. Custom cabinets and special-order windows carry lead times that start at the order, not at install.

Change orders after groundbreaking cost time and money. Heavy rain pauses slabs and brick or siding. Labor in the skilled trades is tight, and a builder without a stable crew list waits longer for the next trade.

Frequently Asked Questions

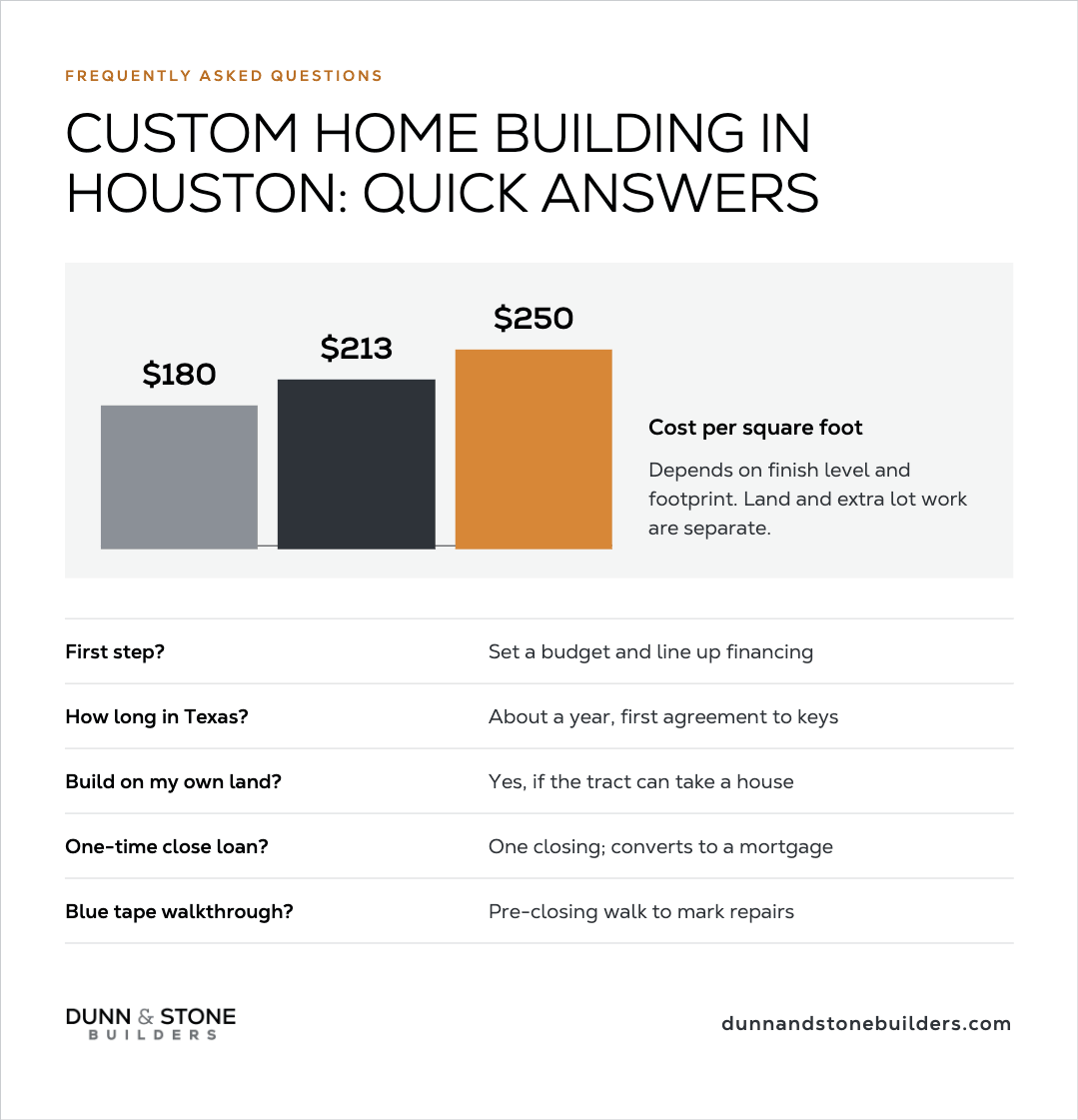

FAQ graphic “Custom Home Building in Houston: Quick Answers”: cost-per-square-foot bars at $180, $213, and $250 (finish level and footprint; land and extra lot work separate) plus quick answers on first step, Texas timeline, building on your own land, one-time close loan, and blue tape walkthrough.

What is the first step in the home building process?

The first step in the home building process is setting a budget and lining up financing. The loan range tells you what size and finish level the house can carry before anyone draws a plan.

How long does the home building process take in Texas?

Most custom homes in Texas take about a year from first agreement to keys when you count design, permits, and the loan, not only the months after groundbreaking.

Can I build a custom home on my own land?

Yes. You can build a custom home on land you already own if the tract can take a house. Soil, drainage, utilities or well and septic, floodplain rules, and any HOA review all have to clear before design is finished.

What is a one-time close construction loan?

A one-time close construction loan funds the build in draws and converts to a permanent mortgage when the house is complete. There is one closing, which is why Texas buyers use it more often than a construction-only loan plus a second mortgage close.

What is a blue tape walkthrough?

A blue tape walkthrough is the pre-closing visit where you and the builder walk every room and mark repairs with painter's tape. It is the last chance to catch finish defects while the builder still has crews assigned to the house.

How much does it cost to build a house in Houston?

Custom homes that we build in the Houston area typically range from $500K - $1.5M (around $180 to $250 per square foot) depending on finish level and footprint. The rate covers the house. Land and extra lot work sit outside it. Use the cost to build a house calculator to see where a plan sits before you lock a design.

If you already have a lot and a budget range, schedule a free consultation and bring the tract information and the plan you are considering.
