How Long Does It Take to Build a House in Texas?

Table Of Contents
Share

Building a custom house in Texas takes about 9 to 14 months from the first agreement to move-in on the homes we build north of Houston, and construction itself averages about 210 days. That's the calendar our families plan around, from the first meeting to the day you get the keys.

I'm Fred Loucks, CEO of Dunn & Stone Builders. I joined the company in 2010 as purchasing manager, bought it in 2019, and work with families on plan design. We've built more than 1,000 homes in the Greater Houston area since 1999.

  • National average, 2025 Census: 8.8 months from authorization to finish (1.4 months to start, 7.4 months of construction), as reported by the National Association of Home Builders
  • Production or spec home: 5 to 8 months of construction
  • Semi-custom home: 8 to 12 months of construction
  • Dunn & Stone custom and semi-custom: about 210 days of construction, 9 to 14 months in total

People ask me how long it takes to build a home, and they usually want one number. I give them two: construction time, and the full calendar from the first agreement through design, soils, permits, and the loan.

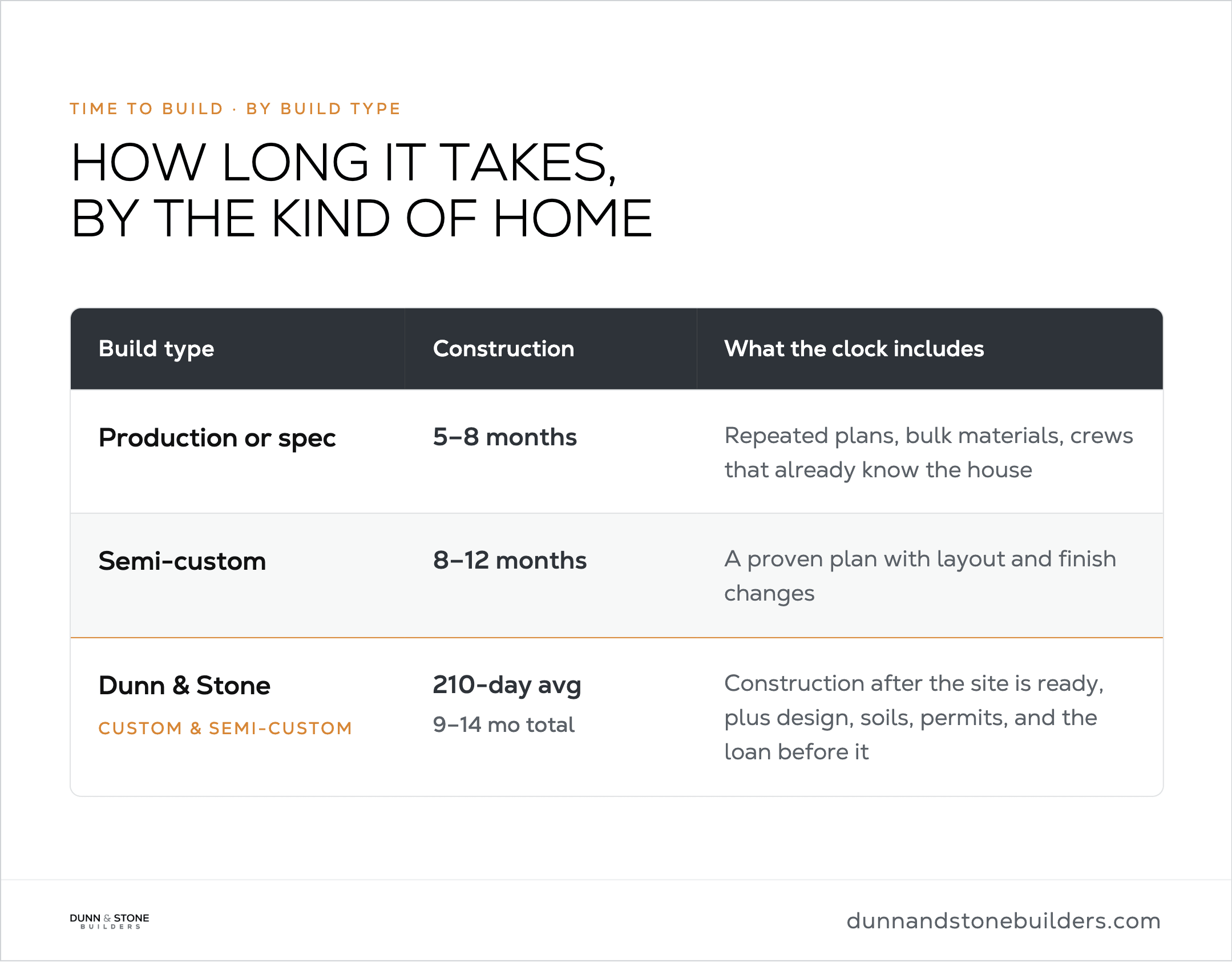

Build typeConstructionWhat that time includes
Production or spec home5 to 8 monthsRepeated plans, bulk materials, crews that already know the house
Semi-custom home8 to 12 monthsA proven plan with layout and finish changes
Dunn & Stone custom and semi-custom210-day construction average, 9 to 14 months total calendarConstruction from groundbreaking to delivery, plus design, soils, permits, and the loan before that

‍

The 8 to 12 months for a semi-custom home is a generic construction range used for comparison. Our own custom and semi-custom homes average about 210 days of construction from groundbreaking.

We count construction from groundbreaking, with the permit in hand, to delivery. The months before that are design, selections, soils, the construction drawings, the loan, and the permit. Those months still count toward your move-in date.

Production or spec construction takes 5 to 8 months. Semi-custom construction is a generic 8 to 12 month range. Dunn & Stone custom and semi-custom homes average about 210 days of construction and 9 to 14 months on the total calendar.

‍

Key Takeaways

  • Construction time and calendar time are different numbers. Construction counts the weeks crews are on site, and the calendar adds design, soils, permits, and the loan.
  • Production builders reuse a plan and a crew. Semi-custom work starts from a proven plan and changes rooms or finishes. A blank-sheet custom house adds coordination on every assembly.
  • Finishes take the largest share of construction time. Late changes in that stretch cost the most weeks.
  • Before construction, Exploration, Design, the final contract, and Build Documents usually take about 5 to 6 months together on a typical projection, and that's where most of the 9 to 14 months goes beyond the 210 days.
  • Near Houston, a complete county permit application usually comes back in about 2 to 3 weeks, and a deed-restricted lot also needs HOA approval.
  • On our own recent builds, size added weeks of construction. Our recent homes under 3,000 sq ft averaged about 194 days of construction, 3,000 to 3,999 sq ft about 207 days, and 4,000 sq ft and up about 238 days.
Custom homes near Houston typically take 9 to 14 months from agreement to keys, with about 210 days of construction. Design through documents is about 5 to 6 months on a typical projection. Finishes take the longest stretch of construction.

‍

How Long It Takes to Build a House in Houston

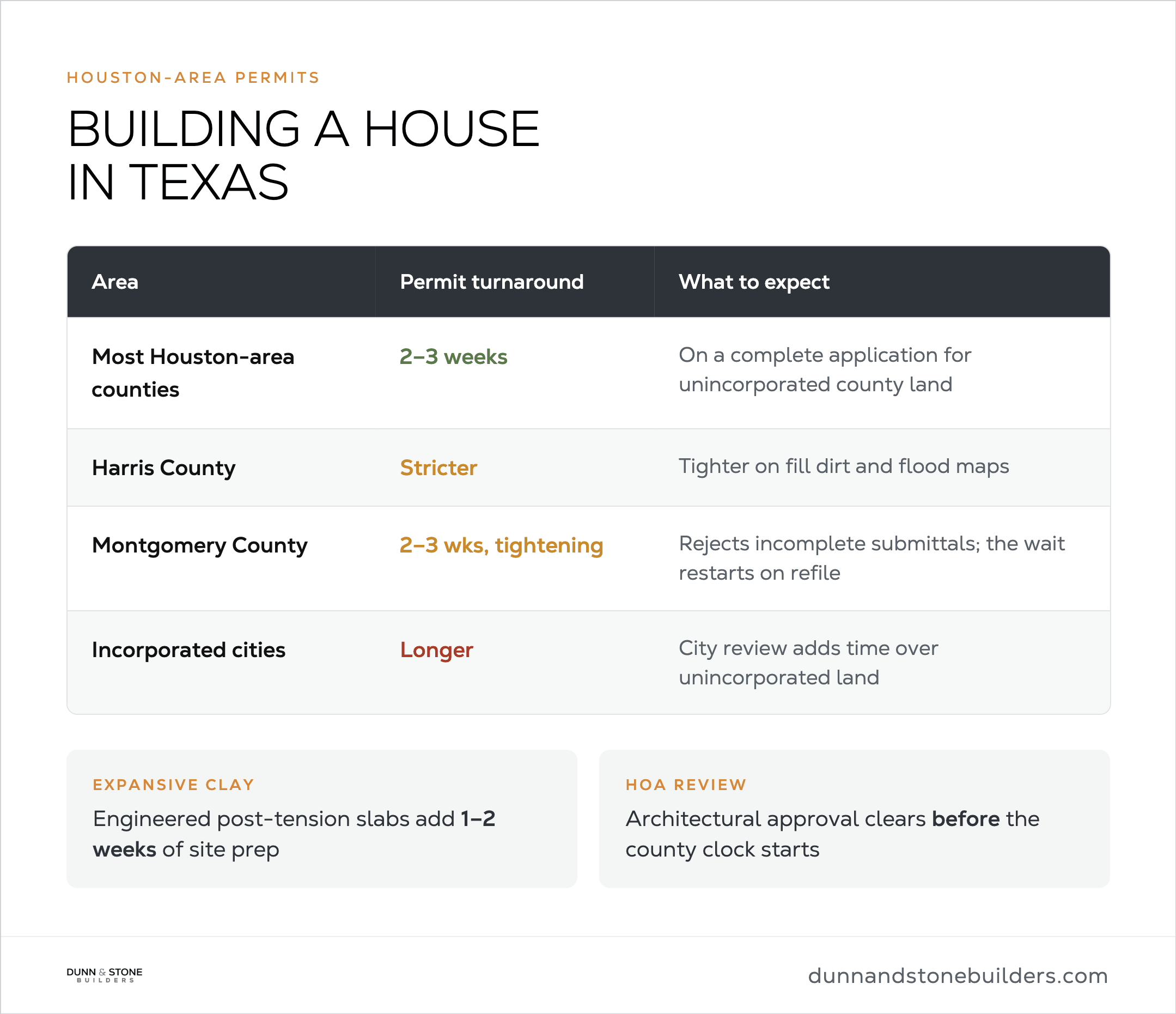

Near Houston, most of our custom and semi-custom homes take 9 to 14 months from first agreement to keys, with about 210 days of construction once we break ground. Permits, HOA review, clay soil, and rain are the local factors that move that date.

Most county offices near Houston issue a permit in about 2 to 3 weeks. Harris County is stricter on fill dirt and flood maps. Montgomery County is moving in that same direction.

Most of the lots I walk sit on expansive clay. Homes here usually need engineered post-tension slabs. That adds a week or two of site prep compared with a simple slab in a drier market.

Skipping the soils report doesn't save that week. It moves the risk into the foundation.

Montgomery County now rejects incomplete applications, and the wait starts over from the new filing. Send every required page the first time. Montgomery County's permit list is what the county asks for.

If the lot is deed restricted, the HOA's architectural committee also has to approve the plans, and we build that review into your calendar. Those permit and HOA steps also change with an acreage lot vs a subdivision lot.

Inside city limits, such as Houston, Conroe, Huntsville, and Tomball, the permit process has more steps than in the county, so we confirm the jurisdiction during Exploration and build it into your calendar.

Building a house near Houston: most families 9 to 14 months, agreement to keys, about 210 days of construction; permits about 2 to 3 weeks if complete; HOA review if the lot is deed restricted; clay soil usually means engineered slabs; rain can move dates.

‍

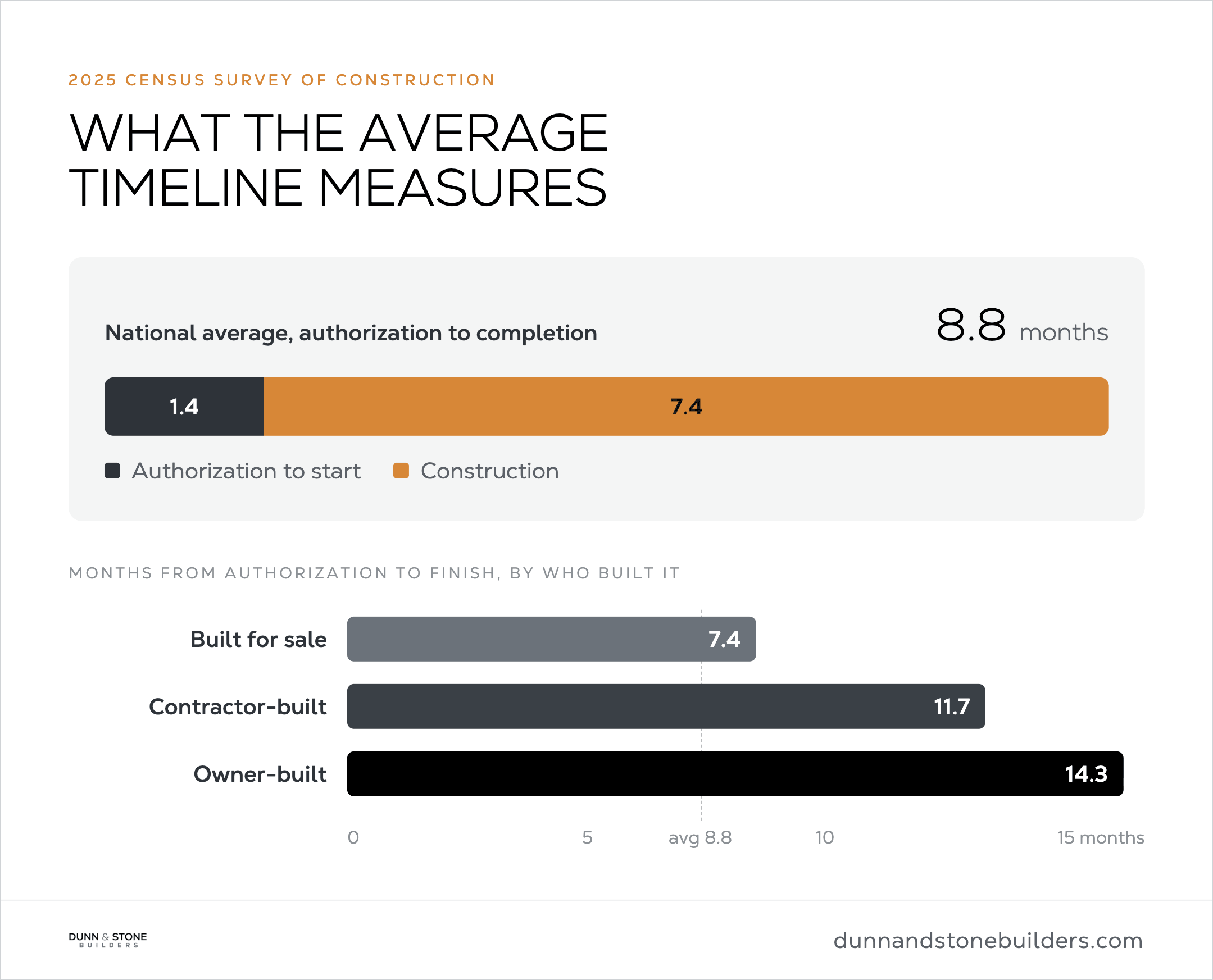

What the Average Timeline Actually Measures

The Census number mixes houses built for sale, houses a contractor builds for one family, and houses people build themselves. Those jobs don't run on the same schedule.

The 2025 Census Survey of Construction, summarized by NAHB, puts the national average at 8.8 months from authorization to completion. Authorization to start is 1.4 months. Construction after that is 7.4 months.

Homes built for sale finished in 7.4 months from permit to completion. Contractor-built homes took 11.7 months on that same measure. Owner-built homes took 14.3 months.

All three count from authorization to finish. They don't count construction only.

The survey starts at the permit. It leaves out the months you spend with me on a floor plan, finish selections, a soils report, or a construction loan.

Those months still happen. They just sit outside the survey window.

We start counting construction the day we break ground. Design, soils, permits, and the loan come first, which is why our custom or semi-custom calendar is 9 to 14 months when construction itself averages 210 days.

NAHB's October 2026 builder survey, published November 10, 2026, puts the average single-family home built for sale at 25.3 weeks of construction, about 5.8 months, on a finished lot. That's a production number. It still leaves out design, the soils report, and the loan, which is why a custom calendar runs longer.

2025 Census: national average 8.8 months authorization to finish (1.4 start wait + 7.4 construction). By who built it: for sale 7.4, contractor-built 11.7, owner-built 14.3 months.

‍

How Long It Takes by Builder Type

A production builder finishes faster because the plan and the crew already exist. They buy materials in bulk. The superintendent has walked that floor plan dozens of times.

Semi-custom work starts from a proven plan, then we change rooms, the elevation, or the finish level. Each change is worth doing when it fits the family.

Each one also adds coordination. I've seen a wall move 2 feet and take a beam, a duct run, and a window order with it.

Fully custom work from a blank sheet runs longer than semi-custom work because every assembly is new to the trades. That's why I start most families from a plan we've already built, then fit it to the lot and the household. Once finishes are chosen on a plan we've already built, we don't have to restart every decision.

If you're still deciding between the two paths, custom and production homes differ in both cost and timeline.

Construction time by builder type: production is faster because the plan and crew already exist; semi-custom starts from a proven plan, then changes rooms or finishes; fully custom from a blank sheet runs longer because every assembly is new.

‍

What Happens Before Construction: Design Through Build Documents

Before we break ground, a Dunn & Stone home moves through four steps: Exploration, Design, the final contract, and Build Documents. On a typical projection those take about 5 to 6 months together, and the 210 days of construction start after them.

PhaseTypical lengthWhat happens
ExplorationAbout 3 weeksLot evaluation, plan evaluation, features and finishes, and a decision on whether to move into design
DesignAbout 3 monthsDraft meetings until the floor plan is stable, the elevation, exterior selections, interior selections, and design complete
Final contractOne meetingFinal contract and an introduction to your builder
Build DocumentsAbout 6 weeksSurvey, soils report, water tap or septic design, full construction set, foundation plans, building permit, construction loan, and any HOA application
ConstructionAbout 210 days on averageClearing and pad through delivery
Total, first meeting to keys9 to 14 months for most families

‍

Those are the lengths on a typical projection. Your own calendar is set in Exploration, and it gets updated at every step until the house is delivered.

‍

Exploration: about 3 weeks

Exploration is a few focused meetings where we check that a plan works on your land and give you early pricing direction before detailed design begins. Lot evaluation comes first, so the lot's fit, drainage, and utilities are on the table before you fall for a layout.

‍

Design: about 3 months

Design is where the floor plan, the elevation, and every selection get settled, in that order. We work the floor plan first, then the elevation, then the exterior and interior selections, and design is complete when the drawings match every decision.

Special-order windows, cabinets, and appliances get ordered during design, so they're already in production when we break ground.

‍

Final contract and Build Documents: about 6 weeks

After the final contract, we order the survey and soils report, finish the construction set and foundation plans, and file for the permit while the construction loan closes. On a deed-restricted lot the HOA application goes in here too.

Payments start with the construction draws, the deposit, and the down payment.

‍

Where design schedules usually stall

Three spots slow a design more than anything else: reopening a floor plan that was already settled, shopping finishes outside the vendors we build with, and saving big changes for the design-complete meeting.

Plan design goes in order, and each decision builds on the one before it. When we circle back to settled decisions, meetings stack up and the schedule slides. It helps to review the drawings at home before design complete, so that meeting confirms the house instead of redesigning it.

Once the contract is signed, later changes become change orders.

Steps 1 to 4: Exploration about 3 weeks, Design about 3 months, final contract one meeting, Build Documents about 6 weeks (about 5 to 6 months together), then about 210 days of construction. First meeting to keys is 9 to 14 months for most families.

‍

Month-by-Month Construction Timeline

Once we break ground, the house moves through foundation, frame, mechanicals, finishes, and closeout. Dates shift from job to job. We still do the steps in the same order.

Locked selections are what keep this table on schedule. Cabinets ordered after the house is framed don't arrive on the week the tile setter is booked.

StageTypical windowWhat happens
Site and foundation3 to 5 weeksClearing, forms, under-slab plumbing, pour, cure, inspection
Framing and dry-in6 to 8 weeksWalls, roof, windows, wrap, roofing
Mechanical rough-in4 to 6 weeksPlumbing, electrical, HVAC, low-voltage, inspections
Insulation and drywall3 to 4 weeksClose the walls
Finishes8 to 12 weeksCabinets, tile, paint, flooring, trim, fixtures, exterior veneer
Closeout2 to 4 weeksPunch list, final inspections, certificate of occupancy where required, walkthrough

‍

Those windows hold when the plan stays stable. A longer driveway, a wet slab week, or a cabinet revision stretches one row and pushes every row after it.

We hand over the house after final inspections, plus a certificate of occupancy where the jurisdiction issues one, and a walkthrough with you.

The house follows the same order as the 5 steps to building a custom home, from the first meeting through keys.

Month-by-month construction after groundbreaking: site and foundation 3 to 5 weeks; framing and dry-in 6 to 8 weeks; mechanical rough-in 4 to 6 weeks; insulation and drywall 3 to 4 weeks; finishes 8 to 12 weeks (longest); closeout 2 to 4 weeks.

‍

How Long It Takes to Build a House by Size

On our recent homes, size added weeks, about six from our smallest size band to our largest. Construction averaged about 194 days for homes under 3,000 sq ft, about 207 days from 3,000 to 3,999 sq ft, and about 238 days at 4,000 sq ft and up, and the full calendar for most families is still 9 to 14 months.

Home sizeAverage construction on our recent homesFull calendar, first meeting to keys
Under 3,000 sq ftAbout 194 days (about 6 and a half months)9 to 14 months
3,000 to 3,999 sq ftAbout 207 days (about 7 months)9 to 14 months
4,000 sq ft and upAbout 238 days (about 8 months)9 to 14 months

‍

These are our own averages from 27 homes we recently delivered, from about 2,400 to 4,400 sq ft, counted from the start of construction to delivery. They are not an industry figure.

A bigger house adds rooms of drywall, tile, and trim, so finishes run longer. The plan's complexity and how settled the selections are can move the date too.

‍

How long does it take to build a 2,000 sq ft house?

A 2,000 square foot house sits at the small end of what we build, and our recent homes under 3,000 square feet averaged about 194 days of construction once we broke ground. Plan on 9 to 14 months in total, because design, soils, permits, and the loan come first.

‍

How long does it take to build a 3,000 sq ft house?

On our recent homes between 3,000 and 3,999 square feet, construction averaged about 207 days, or about 7 months, once we broke ground. From the first agreement to move-in, most families plan on 9 to 14 months.

‍

How long does it take to build a 4,000 sq ft house?

Our recent homes of 4,000 square feet and up averaged about 238 days of construction, or about 8 months, once we broke ground. Add design, soils, permits, and the loan, and most families are on a 9 to 14 month calendar.

On 27 recent Dunn & Stone homes, construction averaged about 194 days under 3,000 sq ft, about 207 days from 3,000 to 3,999 sq ft, and about 238 days at 4,000 sq ft and up. The full calendar for most families is still 9 to 14 months.

‍

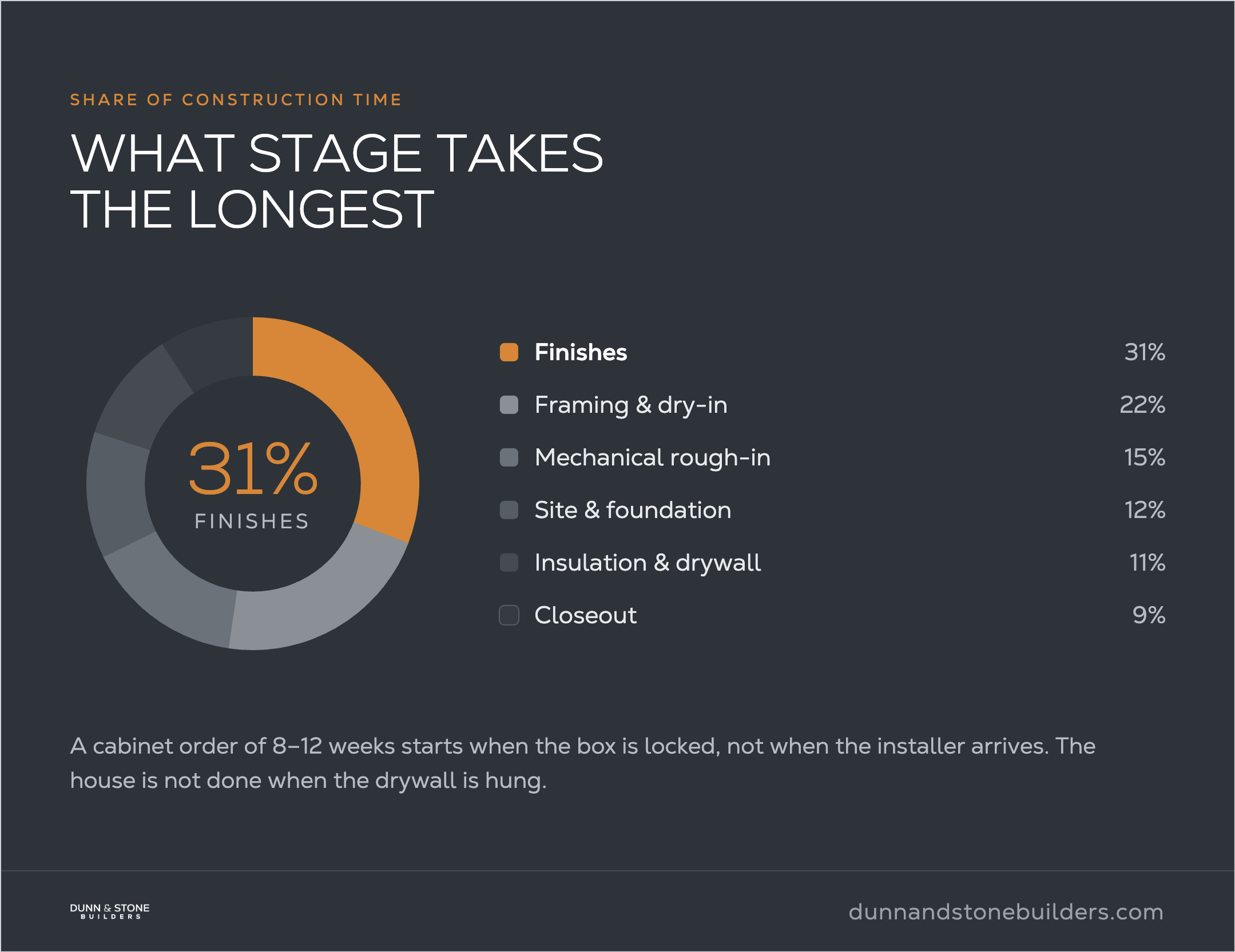

What Stage Takes the Longest

Finishes surprise people. On the jobs I run, they take more construction weeks than foundation or framing.

Cabinets, tile, paint, flooring, and fixtures have to work one room at a time. Cabinets take 8 to 12 weeks after you approve the order. That wait starts when the order goes in, not when the installer shows up.

Foundation and framing look farther along than they are. I still have to tell families we have months of work left after the drywall goes up.

Builders nationally say the same. NAHB's October 2026 builder survey found interior finishes take 6.4 weeks on a home built for sale, longer than any other stage, with framing and rough-ins next at 3.7 weeks each.

Longest construction stage: finishes, 8 to 12 weeks; cabinet lead time 8 to 12 weeks after you approve the order. NAHB, homes built for sale: interior finishes 6.4 weeks; framing or rough-ins 3.7 weeks each.

‍

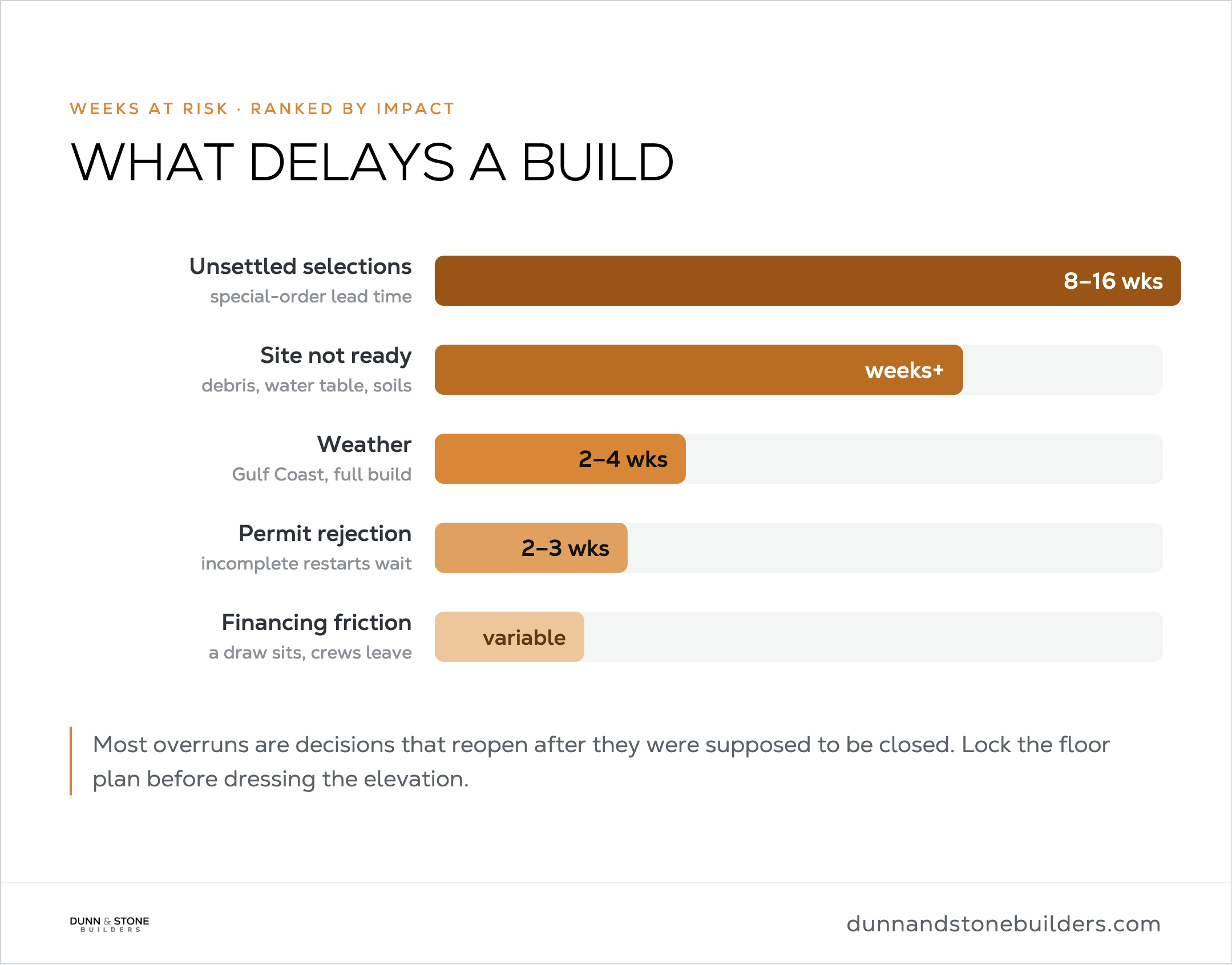

What Delays a Build

A calendar can slip. On our jobs, each of the usual slips already has a place in our process, so I don't treat one as a crisis.

The first one I watch is a finish that is still open. Special-order windows, cabinets, and appliances can take 8 to 16 weeks, which is why we place those orders during design. If someone wants a piece from a store our trades don't stock, we find an equivalent our partners already install.

We settle the floor plan first, then the elevation. That keeps design meetings from stacking. If a room still needs another look, we do it before the construction drawings go out.

In our design center we stay with vendors we already build with and warrant. When we sit down for design complete, we walk the drawings against what we already decided. If a bedroom still needs to move, we move it in that meeting, before walls are framed.

If the building-permit application is complete the first time, most county offices near Houston issue that permit in about 2 to 3 weeks. Missing pages make the county reject the application, and the wait starts over.

Site work is easier when we see the lot early. Buried debris, a high water table, or a tricky soils report is easier to handle when we see it before we pour, because we can still change the foundation and the access path.

Bank payments go out on time when the loan is already in place. We close the construction loan during Build Documents, before we break ground, so a crew isn't waiting on the bank.

I also ask families to leave 30 to 60 days between the projected delivery and a lease end, a school start, or a home sale. That extra time covers a wet week or a late inspection.

What usually delays a build: special-order windows, cabinets, and appliances 8 to 16 weeks; a complete county permit near Houston about 2 to 3 weeks; leave a 30 to 60 day buffer before move-in.

‍

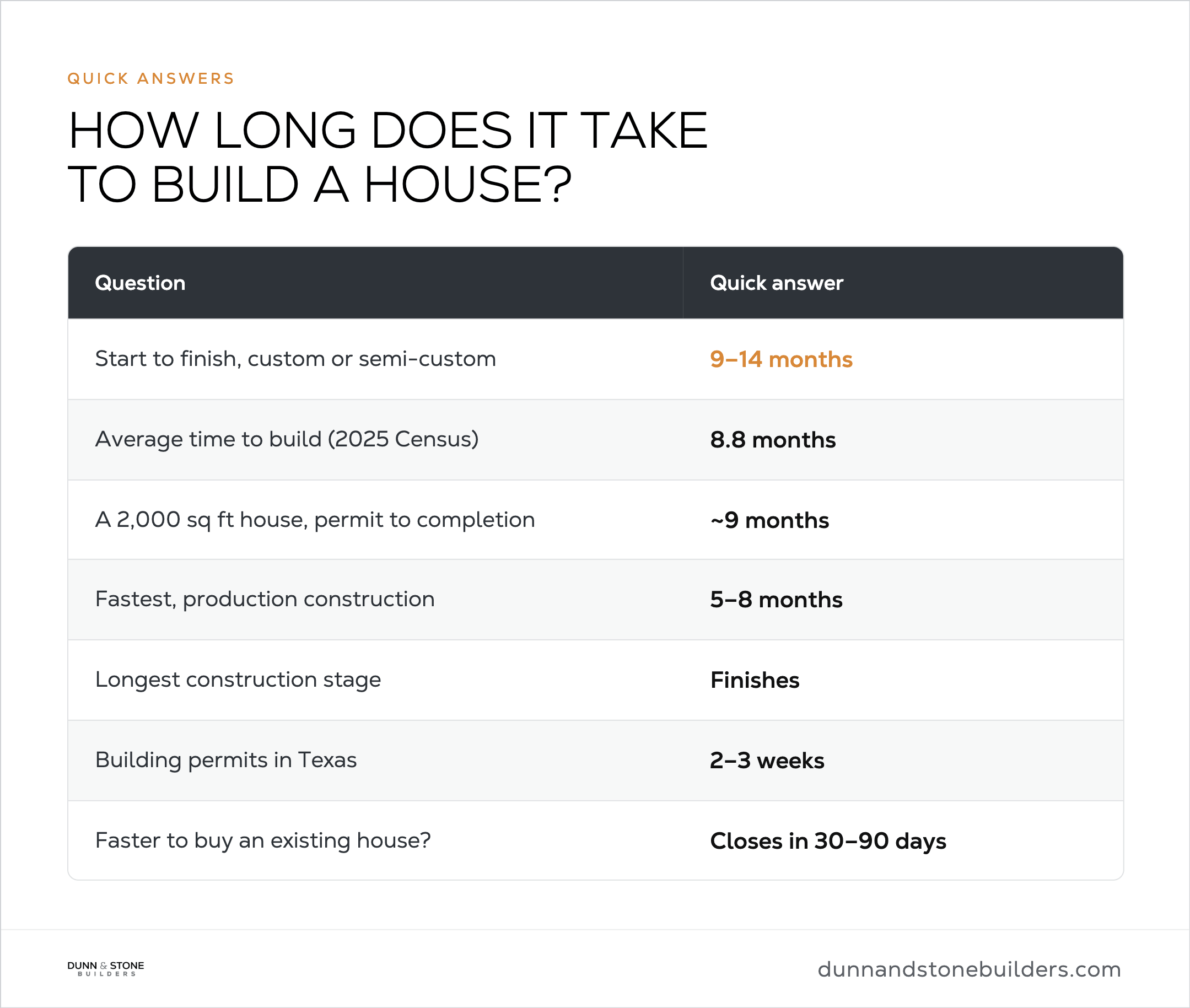

Frequently Asked Questions

‍

How long does it take to build a house from start to finish?

Most of our custom and semi-custom houses take 9 to 14 months from first agreement to keys. Construction itself runs about 7 months once we break ground. Design, soils, permits, and the loan fill the months before that.

‍

What is the average time to build a house?

The 2025 Census average is 8.8 months from authorization to finish, with 7.4 months of construction. Homes built for sale finished in 7.4 months.

Contractor-built homes took 11.7 months from permit to completion. Owner-built homes took 14.3 months on that same measure. NAHB's October 2026 survey puts construction alone at 25.3 weeks for a home built for sale.

‍

How long does it take to build a custom home?

With us, a custom or semi-custom house usually takes 9 to 14 months from first agreement to move-in. A blank-sheet plan runs longer than a proven plan with locked selections, and those extra months sit in design, soils, permits, and the loan, not only in framing.

‍

How long does the design phase take for a custom home?

On a typical Dunn & Stone projection, Exploration takes about 3 weeks, Design about 3 months, and Build Documents about 6 weeks, so most families spend about 5 to 6 months before construction starts.

‍

How long does it take to build a house in Houston?

Most of our custom and semi-custom homes near Houston take 9 to 14 months from first agreement to move-in, with construction averaging about 210 days once we break ground.

‍

What stage of building a house takes the longest?

Finishes take the most construction weeks on the houses we build. The trades work in sequence, and a late change in that stretch costs the most time. Foundation and framing move faster than they look.

‍

How fast can you build a house?

Production construction usually takes 5 to 8 months. A custom house of typical family size usually needs more than 4 months of construction. When a quote is that short, ask whether it includes design, the soils report, and the permit.

‍

Is it possible to build a house in 3 months?

Building a custom house in 3 months is rare, because construction alone on a typical home built for sale averages about 25 weeks nationally. Ours average about 210 days once we break ground, and design and permits come before that.

‍

How long do building permits take in Texas?

If the building-permit application is complete the first time, most county offices near Houston issue that permit in about 2 to 3 weeks. Missing pages make the county reject the application, and the wait starts over. If the lot has an HOA, its architectural review is a separate approval.

‍

Is it faster to buy a house than to build one?

Buying an existing house usually closes in about 30 to 45 days once your offer is accepted. Building takes longer. It still makes sense when the resale inventory doesn't match the lot or the layout.

If you already own land, the choice is whether to build on land you own or buy a Houston resale.

‍
